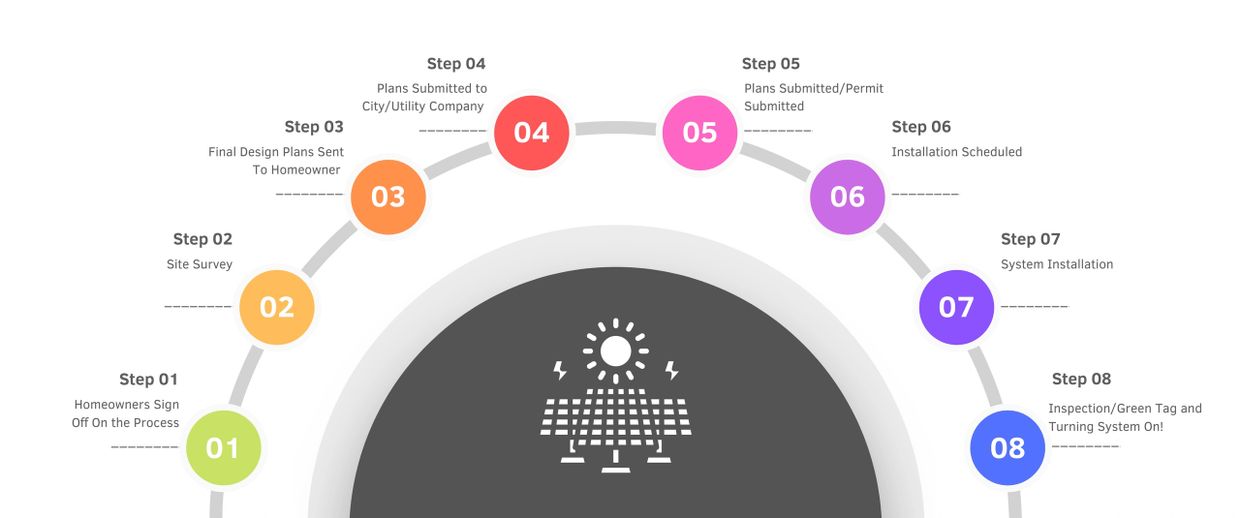

Please be aware that the timeline provided is an estimate of when your solar system will be installed and activated. There may be factors that cause the installation to be completed earlier or later than expected. The following is a breakdown of the estimated timeline:
- Project start: This occurs after the installation documents and financing documents (if applicable) are signed and sent to the installers and bank.
- Site survey: This process, which typically takes 5-7 days after the documents have been signed, involves assessing the suitability of your home and roof for solar panel installation.
- Final design: The installers will review the initial design to ensure that the system will produce the expected amount of energy and make any necessary adjustments to the design for optimal appearance. This stage typically takes 14-21 days.
- Plans submitted: As this is a construction project, the plans must be submitted to the utility company and city/county for approval. This process typically takes 21-25 days.
- Plans approved and permit submitted: Once the plans have been approved and signed off, they are submitted for the necessary permits. This process takes 25-55 days.
- Installation scheduled: Once the permits have been approved and submitted, the installers will schedule a date for the installation of your system. This process takes 55-60 days.
- System installation: The day of the installation, the installers will come to your home and install the solar panels. This process takes 60-75 days.
- Inspection and green tag: After the system has been installed, an inspector will visit your home to ensure that everything has been installed correctly and give you the green light to activate the system. This process takes 75-90 days.
- System activation: Once the inspection has been completed and the green tag has been issued, your solar system will be activated and ready for use.
